Page 112 - Nurol YES Sustainability Report
P. 112

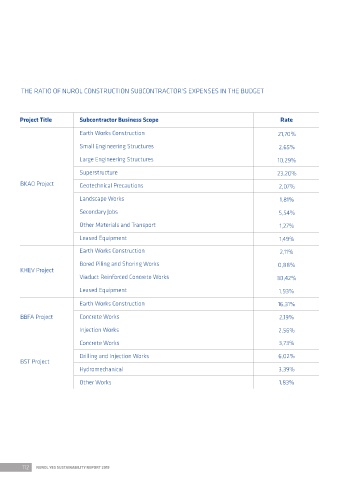

THE RATIO OF NUROL CONSTRUCTION SUBCONTRACTOR'S EXPENSES IN THE BUDGET                                                  THE RATIO OF NUROL CONSTRUCTION SUPPLIER EXPENSES IN THE BUDGET





        Project Title        Subcontractor Business Scope                                           Rate                       Project Title        Supplied Material                                                      Rate
                             Earth Works Construction                                              21,70%                                           Concrete                                                               8,63%

                             Small Engineering Structures                                          2,65%                                            Pre-Stretched Steel Wire Rope                                          1,12%

                             Large Engineering Structures                                          10,29%                      BKAO Project         Expansion Joints                                                       0,37%

                             Superstructure                                                       23,20%                                            Aggregate                                                              2,81%

        BKAO Project         Geotechnical Precautions                                              2,07%                                            Pipes and Fittings Materials                                           0,62%

                             Landscape Works                                                       1,81%                                            Concrete                                                               7,85%

                             Secondary Jobs                                                        5,54%                                            Iron                                                                  26,66%
                                                                                                                               KHEV Project
                             Other Materials and Transport                                         1,27%                                            Aggregate                                                              0,58%

                             Leased Equipment                                                      1,49%                                            Steel Rope                                                             6,72%

                             Earth Works Construction                                              2,11%                                            Cement                                                                 0,57%

                             Bored Piling and Shoring Works                                        0,88%                                            Iron                                                                   2,79%
        KHEV Project
                             Viaduct Reinforced Concrete Works                                    30,42%                       BBFA Project         Explosive Materials                                                    2,30%

                             Leased Equipment                                                      1,93%                                            Crushed                                                                0,46%

                             Earth Works Construction                                              16,31%                                           Additive                                                               0,28%

        BBFA Project         Concrete Works                                                        2,19%                                            Rock                                                                   8,62%

                             Injection Works                                                       2,56%                                            Concrete                                                               7,10%
                                                                                                                               BST Project
                             Concrete Works                                                        3,73%                                            Injection Mortar                                                       0,64%

                             Drilling and Injection Works                                          6,02%                                            Explosive Materials                                                    1,19%
        BST Project
                             Hydromechanical                                                       3,39%

                             Other Works                                                           1,83%
