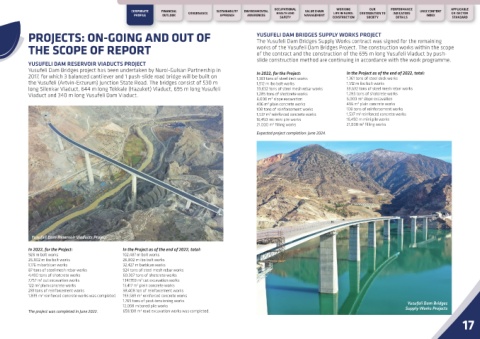

PROJECTS: ON-GOING AND OUT OF YUSUFELI DAM BRIDGES SUPPLY WORKS PROJECT
The Yusufeli Dam Bridges Supply Works contract was signed for the remaining
THE SCOPE OF REPORT works of the Yusufeli Dam Bridges Project. The construction works within the scope
of the contract and the construction of the 695 m long Yusufeli Viaduct by push-
slide construction method are continuing in accordance with the work programme.
YUSUFELI DAM RESERVOIR VIADUCTS PROJECT
Yusufeli Dam Bridges project has been undertaken by Nurol-Gulsan Partnership in
2017, for which 3 balanced cantilever and 1 push-slide road bridge will be built on In 2022, for the Project: In the Project as of the end of 2022, total:
1,361 tons of steel deck works
1,361 tons of steel deck works
the Yusufeli (Artvin-Erzurum) Junction State Road. The bridges consist of 530 m 1,512 m ibo bolt works 1,512 m ibo bolt works
long Silenkar Viaduct, 644 m long Tekkale (Hazuket) Viaduct, 695 m long Yusufeli 33,632 tons of steel mesh rebar works 33,632 tons of steel mesh rebar works
Viaduct and 340 m long Yusufeli Dam Viaduct. 1,285 tons of shotcrete works 1,285 tons of shotcrete works
3
6,000 m slope excavation 6,000 m slope excavation
3
3
3
496 m plain concrete works 496 m plain concrete works
108 tons of reinforcement works 108 tons of reinforcement works
3
1,537 m reinforced concrete works 1,537 m reinforced concrete works
3
16,450 mt mini pile works 16,450 m mini pile works
3
21,000 m filling works 21,000 m filling works
3
Expected project completion: June 2024.
Yusufeli Dam Reservoir Viaducts Project
In 2022, for the Project: In the Project as of the end of 2022, total:
928 m bolt works 102,487 m bolt works
26,802 m ibo bolt works 26,802 m ibo bolt works
1,176 m barbican works 32,427 m barbican works
87 tons of steel mesh rebar works 924 tons of steel mesh rebar works
4,490 tons of shotcrete works 60,307 tons of shotcrete works
3
7,757 m cut excavation works 1,147,159 m cut excavation works
3
3
122 m plain concrete works 13,417 m plain concrete works
3
281 tons of reinforcement works 38,408 ton of reinforcement works
1,839 m reinforced concrete works was completed. 193,589 m reinforced concrete works
3
3
1,765 tons of post-tensioning works Yusufeli Dam Bridges
12,098 m bored pile works Supply Works Projects
3
The project was completed in June 2022. 658,138 m road excavation works was completed.
